Your cut is a little more forward of where I cut mine at. My cut was about even with the rear most body mount. You'll need to wait until you have the Savvy brackets to weld on the raised body mounts becasue the brackets need to be in place first.
It looks REALLY GOOD.

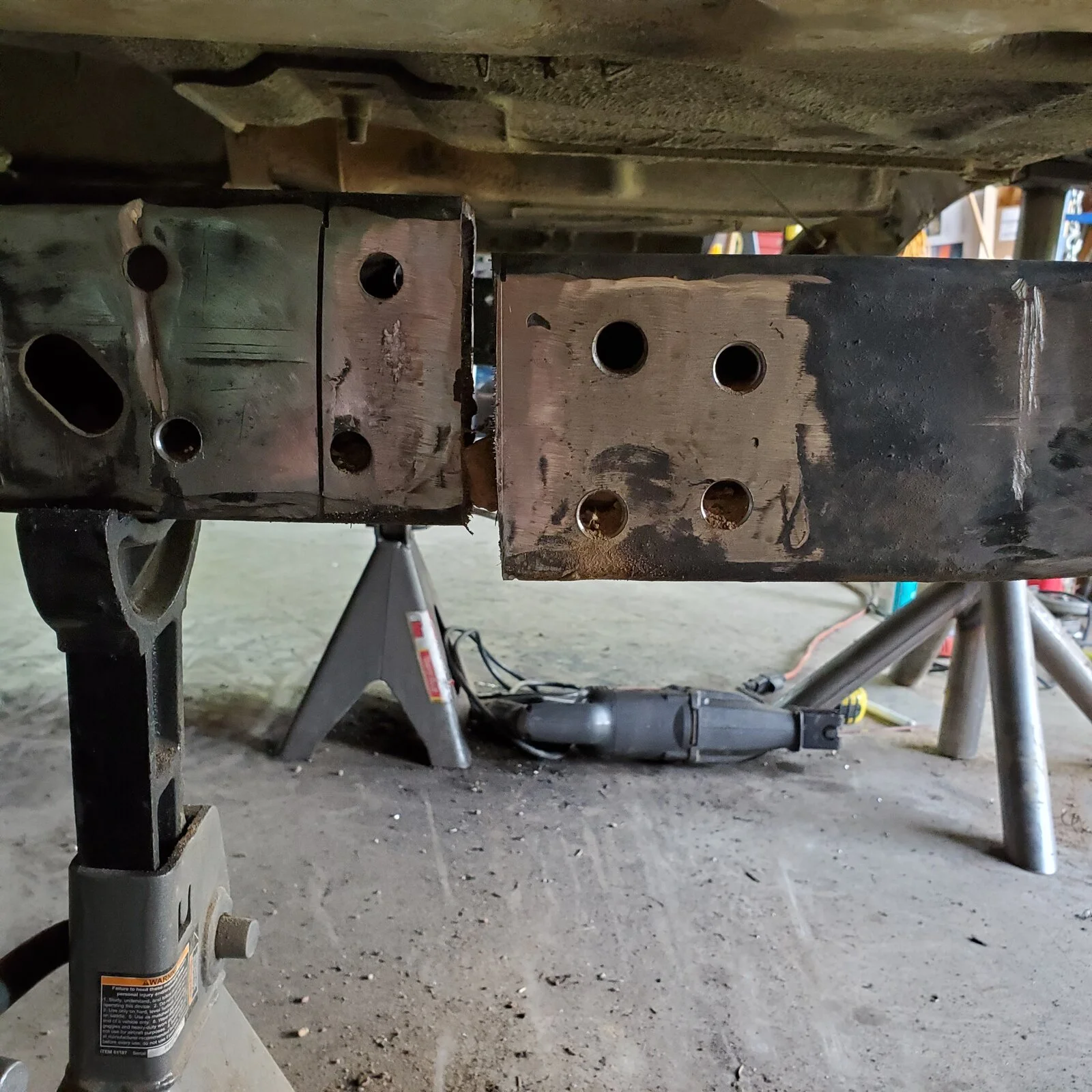

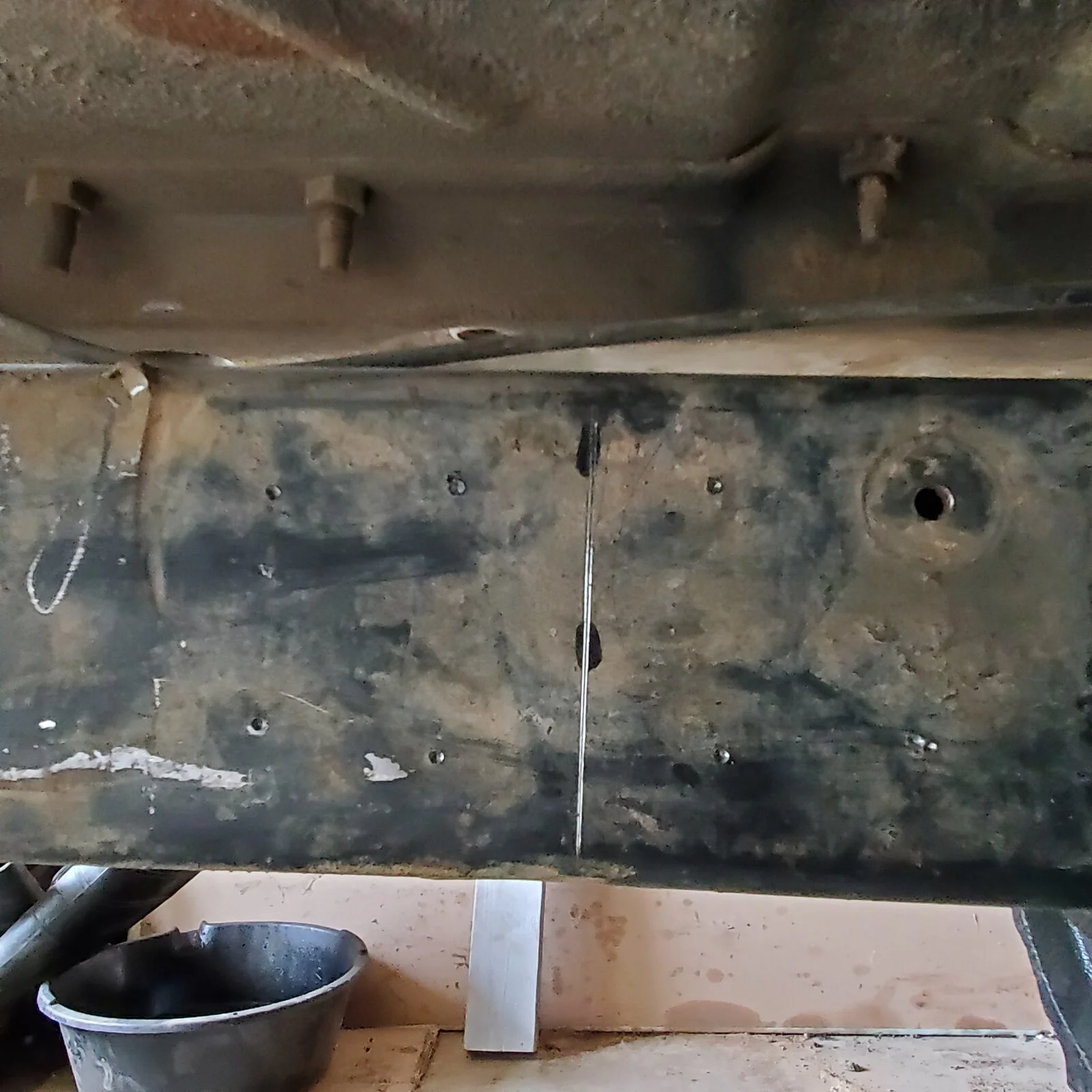

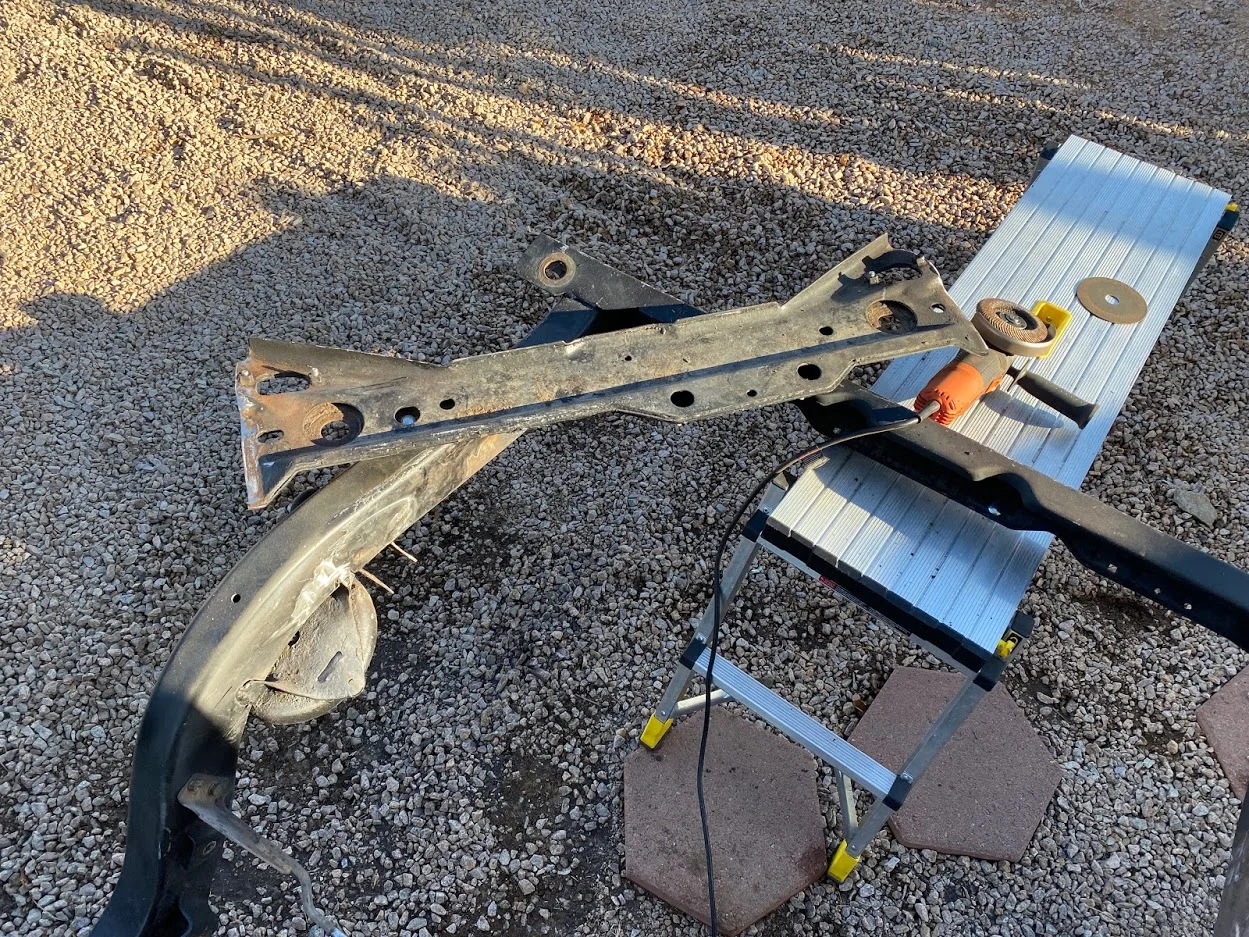

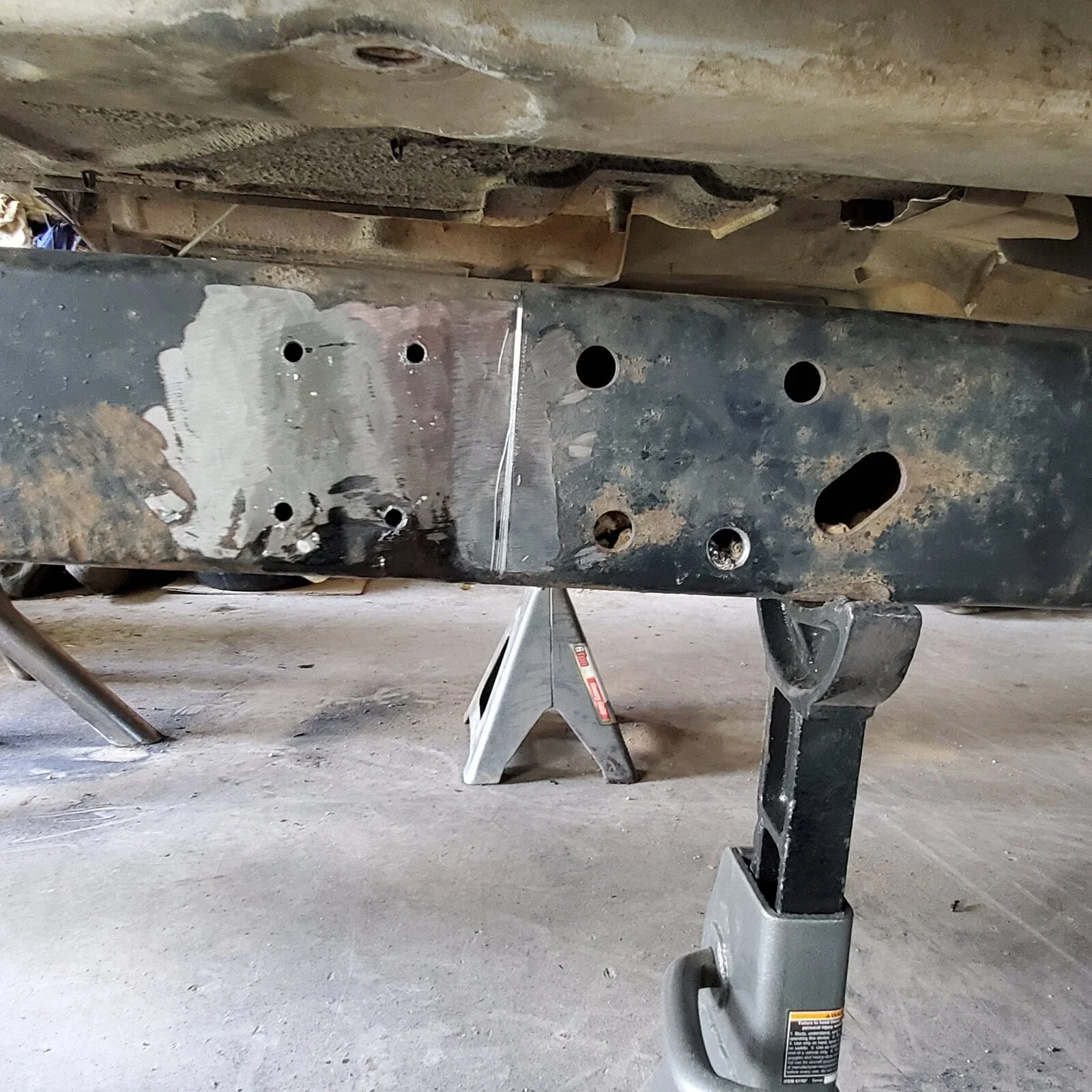

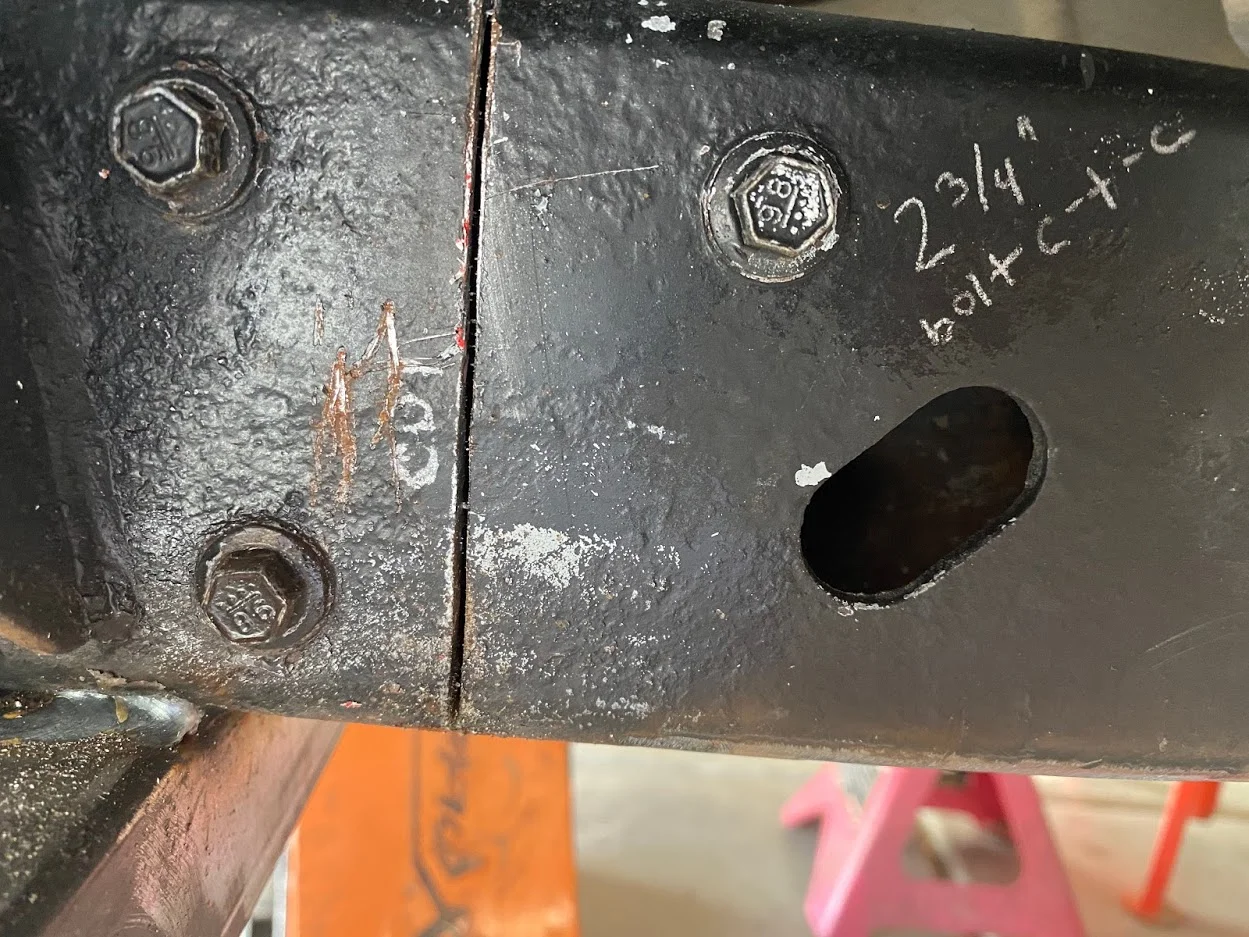

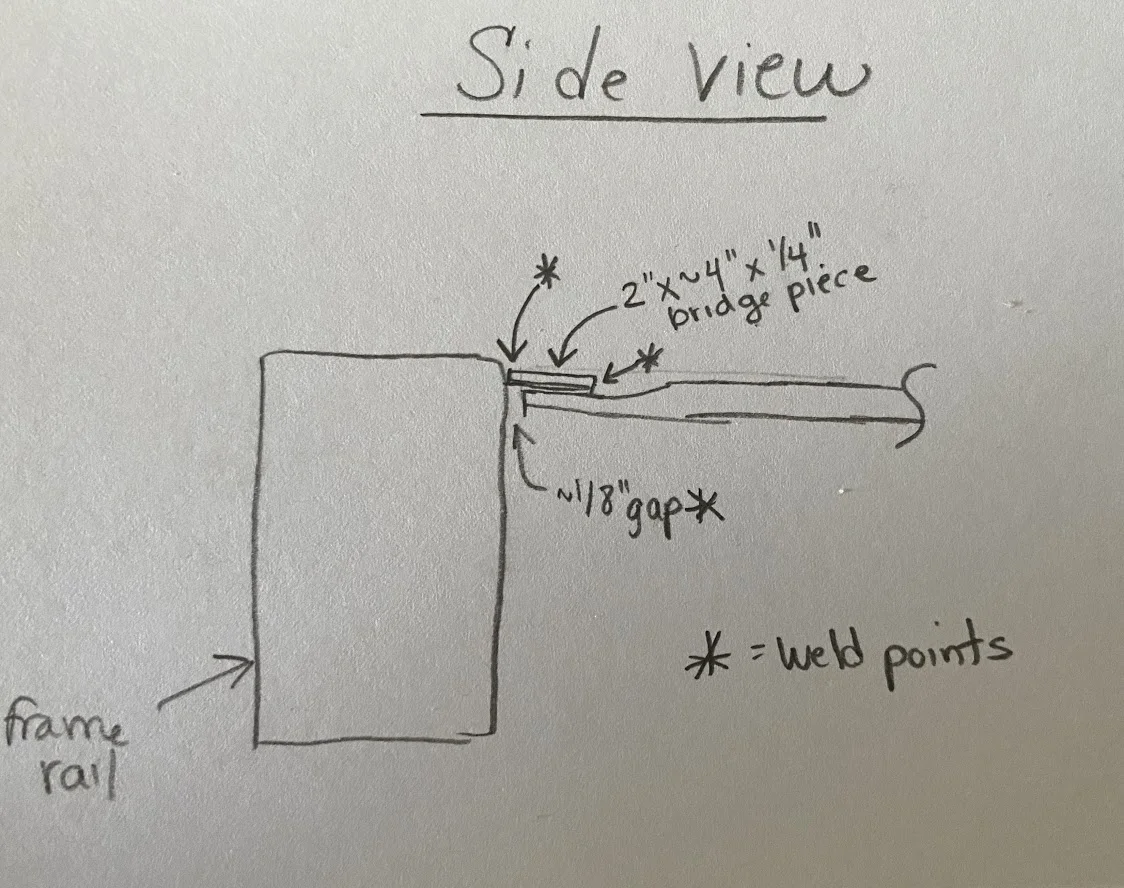

Based on the 5" frame extension with 3" of 1/8" sticking out each end, I put my cut where I had slightly over 3" of "free" space forward of the cut (with plenty behind). This is where most of the TJ-6 guys make the cut and I know they have had good success with this location, so I duplicated it. Seems like there are a few ways to skin the cat here??
What do you mean the body mount bracket can't be welded until the Savvy bracket is in place?

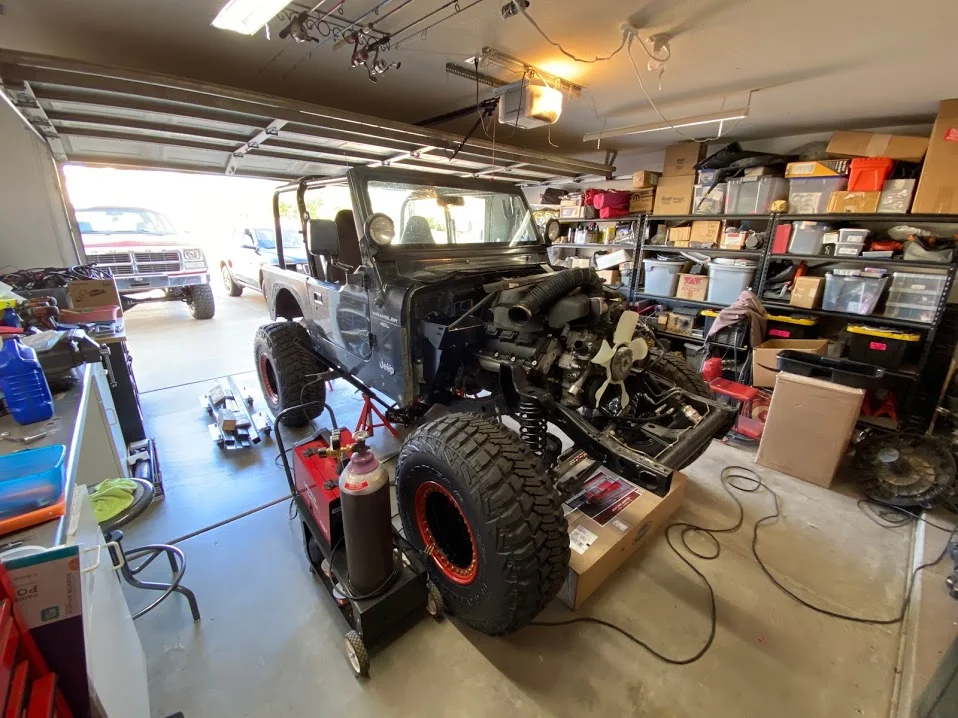

The Savvy mid-arm bracket and link kit is on backorder; I need to message them again to see if they have a timeline for shipment. My plan at this point in time it to get the frame extensions welded in place with the body installed, while getting the crossmembers welded (or mostly welded) in place. Once done, I will get the axle and suspension set back underneath and get the rig off of the jack stands.

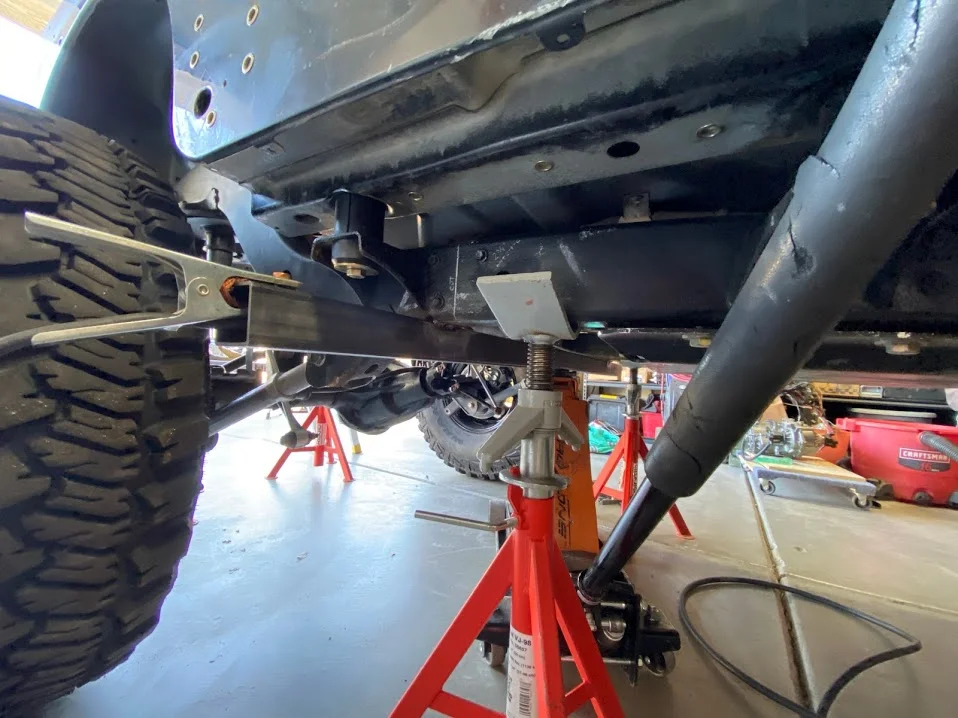

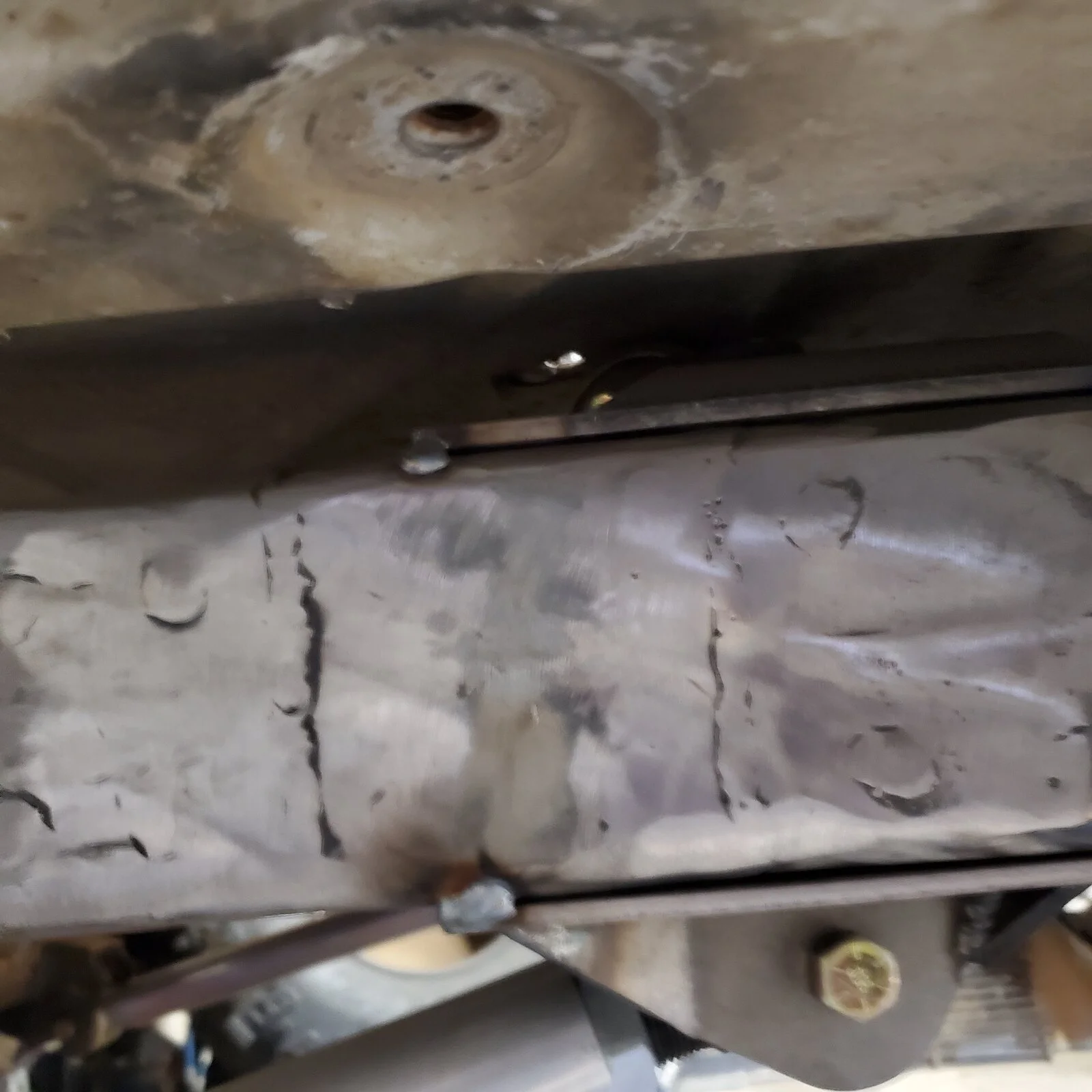

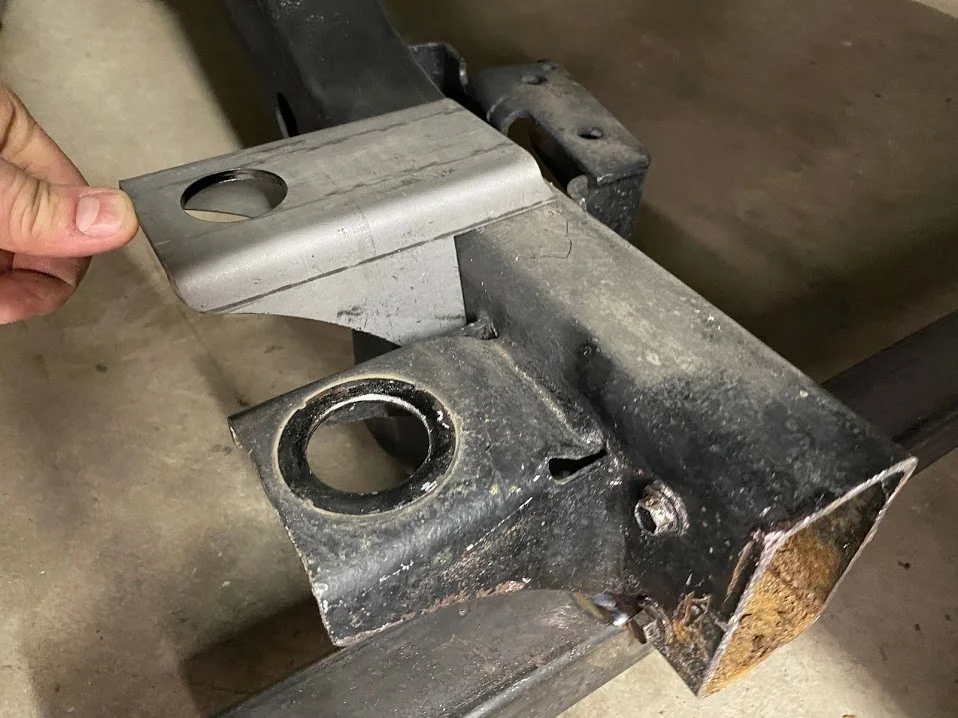

Most of the TJ-6 guys fishplate the outside and inside (around the suspension mounts if applicable) of the frame rails. I saw that Blaine doesn't typically fishplate the outside of his, so I'm not sure if I'm going to or not. I won't be able to complete the inside fishplate until the tub is off and I have the Savvy mounts in hand, is that what you're talking about??

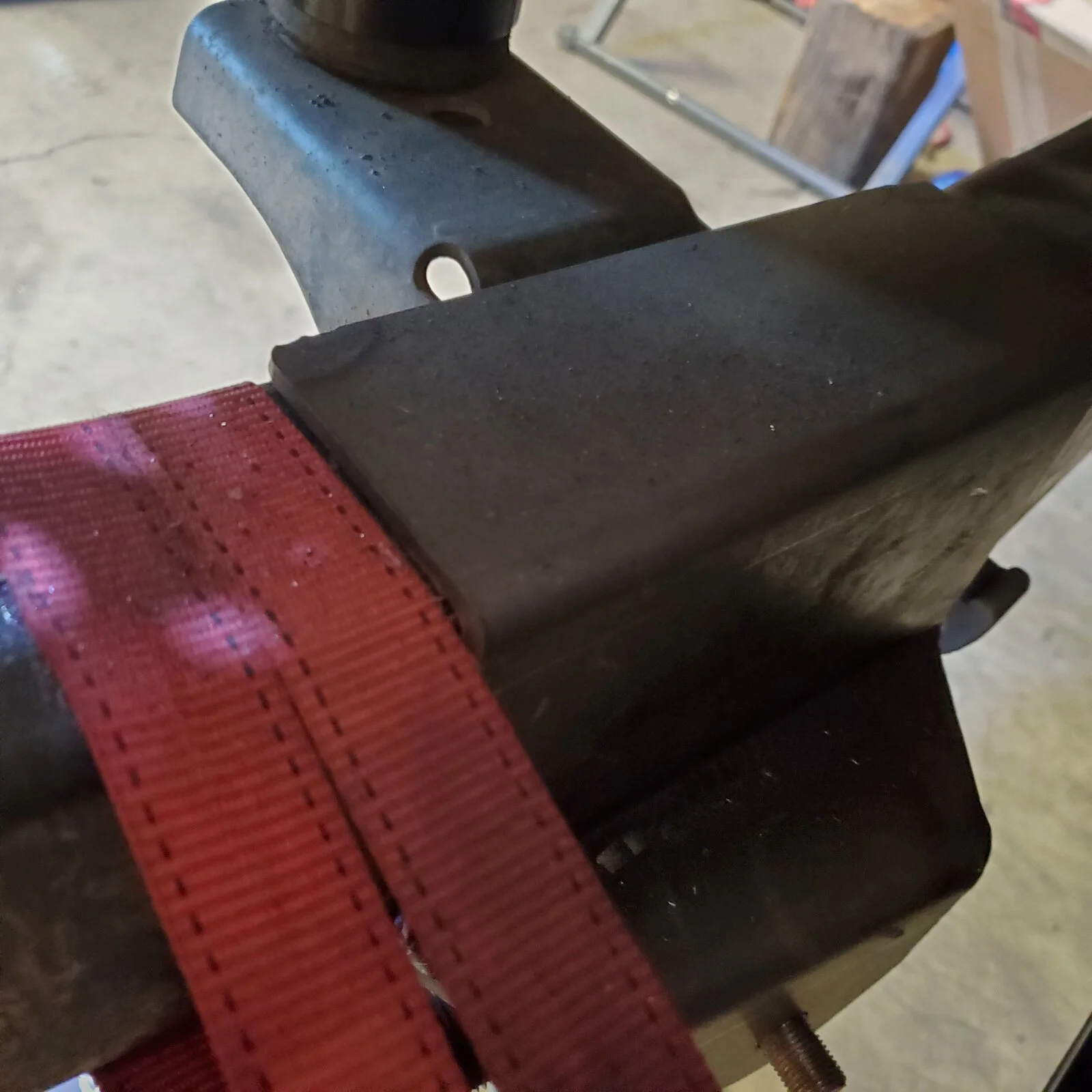

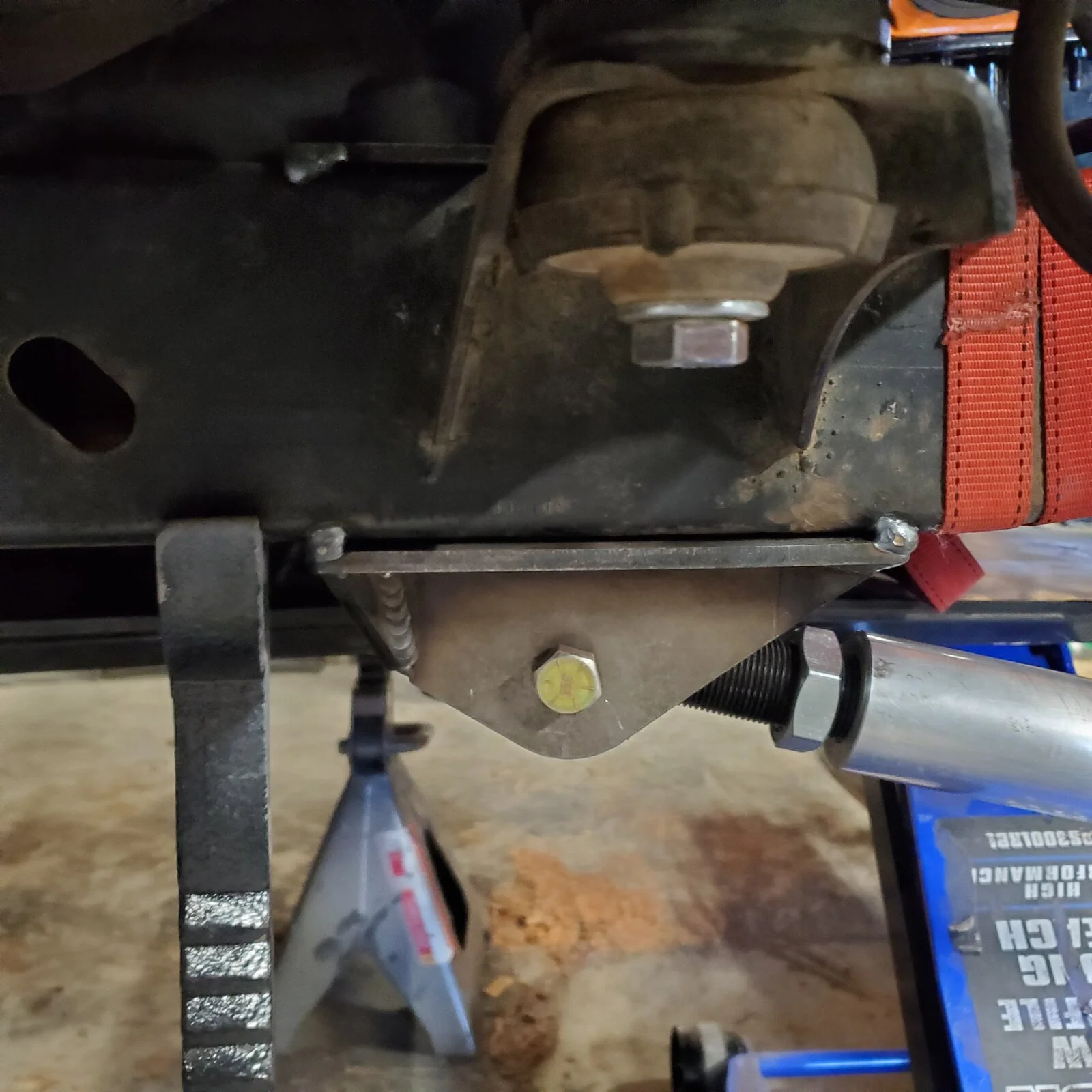

Once the Jeep is back on her tires, I will then cut off the center body mounts and replace with the GenRight ones (just tacked in place). This will let me get the tub pulled, which will allow me to do the final weldment of the crossmembers and body mounts - and should make the placement/weldment of the Savvy brackets much easier.
I must of been a totally blind fucking monkey cause I screwed up my cuts.....
But I can't seem to cut a straight line to save my life.
Mine still needs to be squared up a tad, but nothing major thankfully! If I were to do it again, I would use a thicker-kerf blade. I think it distorted ever so slightly on the driver-side cut towards the bottom and a thicker kerf would (in theory) stay a tad more true.
What's your ETA for this thing to be up-and-running by at this point?
Good question - here's my roughly-updated timeline:
March: finish stretch, replace body mounts, pull tub, begin paint prep
April: finish paint, complete Savvy/suspension work
May: put tub back on, HVAC box rebuild, reassemble front end, wire engine, install exhaust
June: gauges, beta test motor/trans around street, make any tweaks as needed
July: put a few hundred miles each week on motor, install A/C, try to get factory cruise working
Aug: BedRug flooring, new seats, interior work; depending on weather, hit up a moderate trail
Sept: go nuts!
Since we have delayed our move and I was able to tackle the stretch and suspension, I am now planning on being back on the trails in Aug/Sept. I expect to be done and back on the road in June, but I'm sure as hell am not going to do my shakedown runs in the peak heat of the summer! I will use June/July to do some rides around town, get my A/C working, see if I can figure out the OEM cruise and get it to work with the Hemi ECM, etc. I'll also use this time to get my flooring done and find some new seats.
In the short term, once I get the tub off, my focus will be on getting it prepped and painted. With summer around the corner, I need to make it a priority, otherwise it will significantly slow me down since paint won't happen until Sept/Oct! My plan is to push the frame out to the side yard and cover it well, which will give me the entire garage to work on the tub, armor, fenders, hood, etc. It shouldn't take me too long to get it all prepped and painted - I'm planning on 2 weeks total (with 2 weekends worth of work).
Once everything is painted, the tub can be moved to either the one side of the garage or to the side yard and I'll park it under a large pop-up tent to keep the sun and elements off of it, while allowing the paint to fully cure and harden. I expect to have the stretch and Savvy/suspension stuff done by end of April (depending on if Savvy can ship these in a reasonable amount of time), which will let me get the freshly-painted tub back on the frame just before the summer heat begins to fully kick in. I have already prepped the wiring harnesses and they're ready to go for the Hemi swap. I will just need to hook them all up, wrap the wire in fresh loom, and then fully get the front completed. ETA there is end of May...
